Phase: Interim Campus Construction: July 10, 2026

Work Completed July 6 – 10

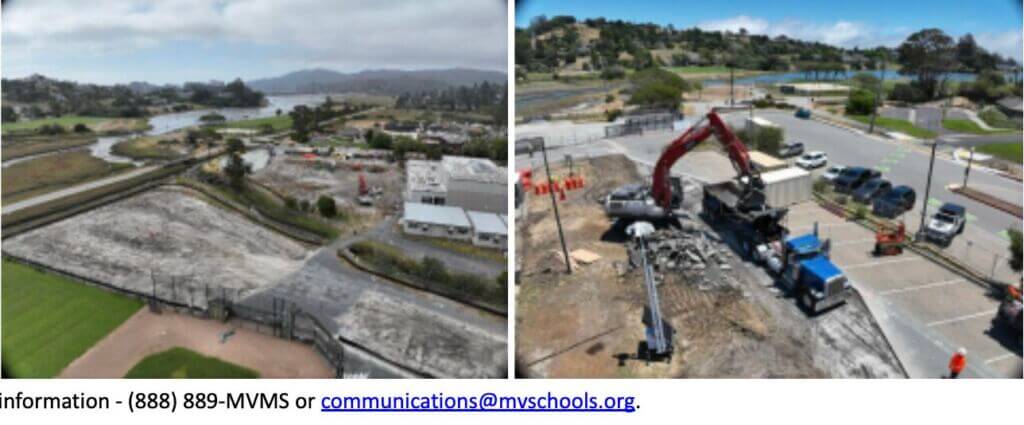

● Continued removal of asphalt and curb sections, then load and haul materials off-site for disposal. ● Continued grading the site.

● Brought equipment to the site and installed a dewatering system.

Work Planned for Week of July 13

● Install dewatering wells on the south and north side of Ryan Creek.

● Begin mass excavation and utility potholing.

● Layout retaining walls.

Anticipated Impacts

● There will be noise and vibrations associated with this work. Air quality will be monitored during all soil  disturbing work.

● Two trucks will enter/exit the site multiple times per day; trucks will be cleaned and covered before leaving the  property.

● Mill Valley Skate Park will be closed from July 6 – August 31st

● Access between Friends Field and Sycamore Avenue is closed for the duration of the project.

Air Monitoring

● Air quality monitoring demonstrated detected levels of methane, volatile organic compounds, and dust (PM10)  are below the action levels established in the Community Air Monitoring Plan.

Work Hours

● 6:00 a.m. and 6:00 p.m., Monday through Friday with weekend work as needed.

● Noisier work will occur between the hours of 7:00 a.m. and 5:00 p.m.

● Some work will occur outside of these hours, and advance notice will be provided.

Site Security

No trespassing – this is an active construction site that is closed to the public.

● Security cameras are in use and monitoring the site 24/7.
